Ebook
Established in 1962, China Construction Fourth Engineering Division Corp., LTD. (hereinafter referred to as “CCFED) is the main subsidiary company of China State Construction Engineering Corporation Limited, which ranks 13th among the world’s top 500 enterprises (2021), the 3rd among China’s top 500 enterprises, and the 1st among ENR’s 2021 top 250 global contractors.
China Construction Fourth Engineering Division has 18 subsidiaries. Its business scope covers fields including infrastructure, real estate development, survey and design, and integrated operation across the whole industry value chain.
Project: Yinhu Station of Shenzhen Metro
Location: On the side road of Beihuan Avenue, Shenzhen, China
Structure:

The schedule was already delayed for half a year, yet the delivery schedule for the project remained unchanged.

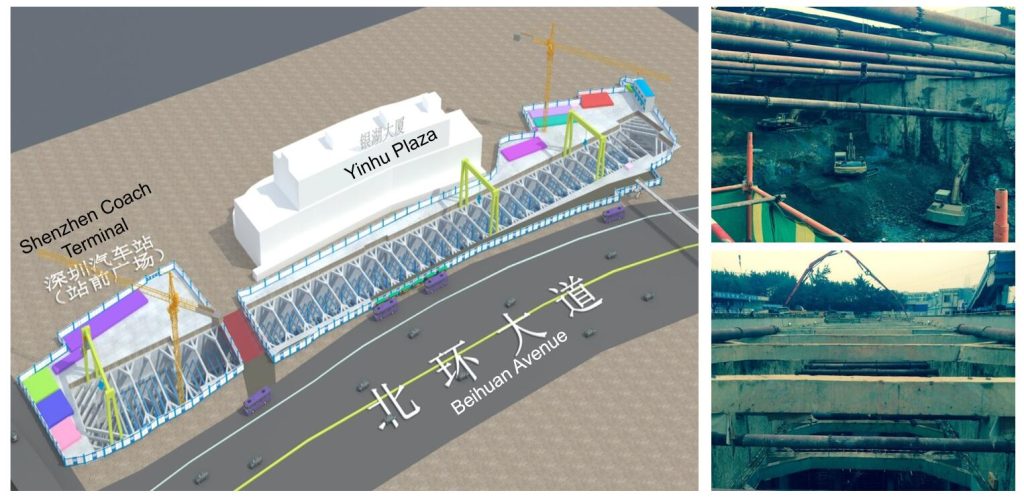

Yinhu metro station is the 13th underground station on Line 9 of Shenzhen Metro, with Line 6 crossing over, connected by its underground level 3. It sits on the side road of Beihuan Avenue, an arterial road that allows vehicles to run at a maximum speed of 80 KM/H. Immediately on the project’s north side stands Yinhu Plaza, a long-distance coach terminal, with an old automobile repair garage nearby – a four-story dilapidated building, both of which make the construction environment very challenging: the coach terminal’s regular functioning and the structure of the garage had to be secured during the construction period.

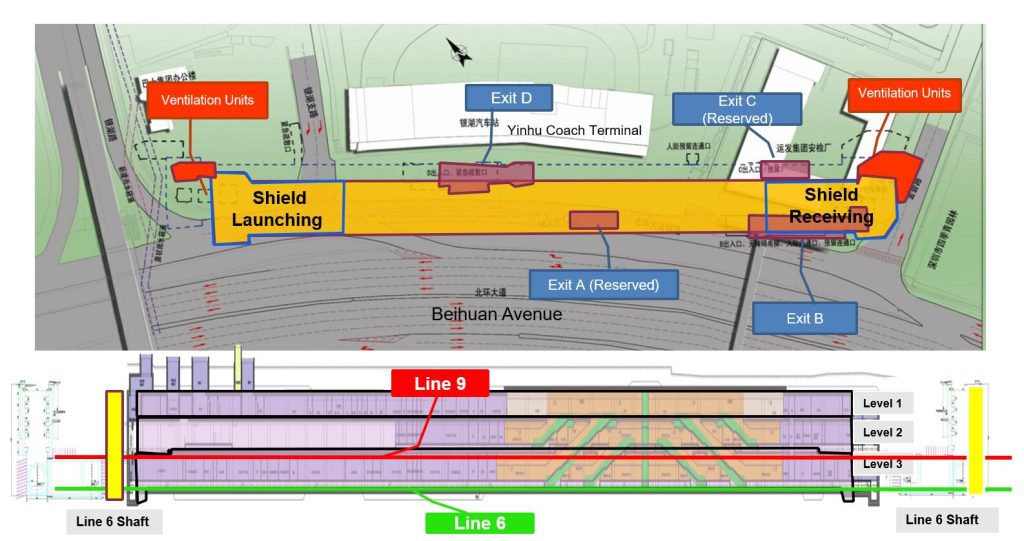

Yinhu station is a critical station on Line 9 because it has “shield launching” on one end and “shield receiving” on the other, which means, if any delay occurs, the tunnel boring machine’s work will be affected, and as a result, the critical construction schedule of the entire Line 9 will be delayed.

The method of cut-and-cover tunneling was applied in this project, namely, digging the trench first, roofing it with an overhead support system, and then starting the structure construction.
By the time China Construction Fourth Engineering Division (CCFED) first started the on-site construction work, the schedule was already delayed for half a year, yet the delivery schedule for the project remained unchanged. CCFED had to ensure that their tunneling shield met the first deadline: Oct. 20. In other words, 65,000 m² of earth had to be evacuated within 112 days, and construction of a 3-level, 2400 m² underground structure had to commence work: enormous project with a tight schedule.
Since the earthwork segment of the project posed greater difficulties than first anticipated, if the project was undertaken in the traditional manner, CCFED risked sacrificing their forecasted margin. If, however, they adopted a leaner project management approach, the project could still remain profitable.
After many deliberations, they ultimately opted for the lean management approach, and implemented iTWO, with the hope to maximize margin and reduce future costs of the project.

1) Visualized collaboration and innovative management process.
2) Accurate analysis and quick feedback.
3) Fast and accurate quantity and estimation.
4) Optimized scheduling and project margin.
5) Integration of virtual and physical.
6) Single source of truth and real-time decision-making.

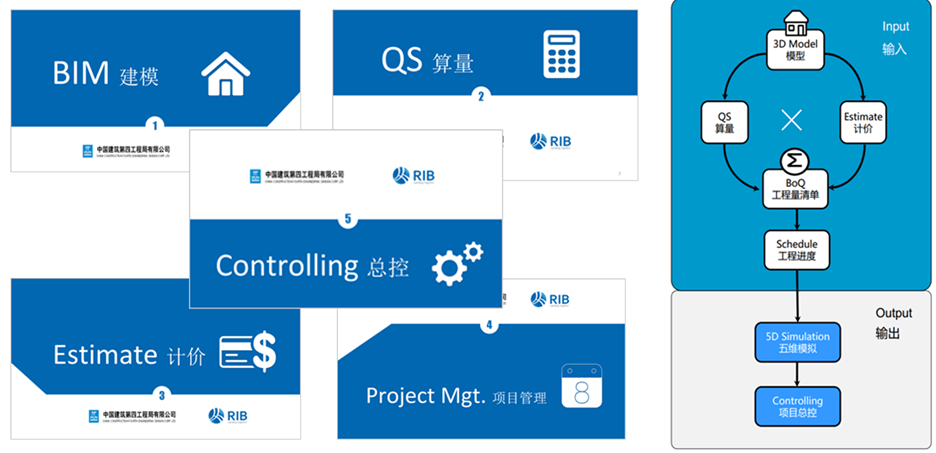

For the Yinhu metro station project, CCFED mainly used Revit and iTWO 5D BIM for the BIM models of earthwork, maintenance structure and main structure of the station. With iTWO’s multi-profession clash detection, 9 construction issues in the drawings were found and were promptly solved, avoiding costly rework.

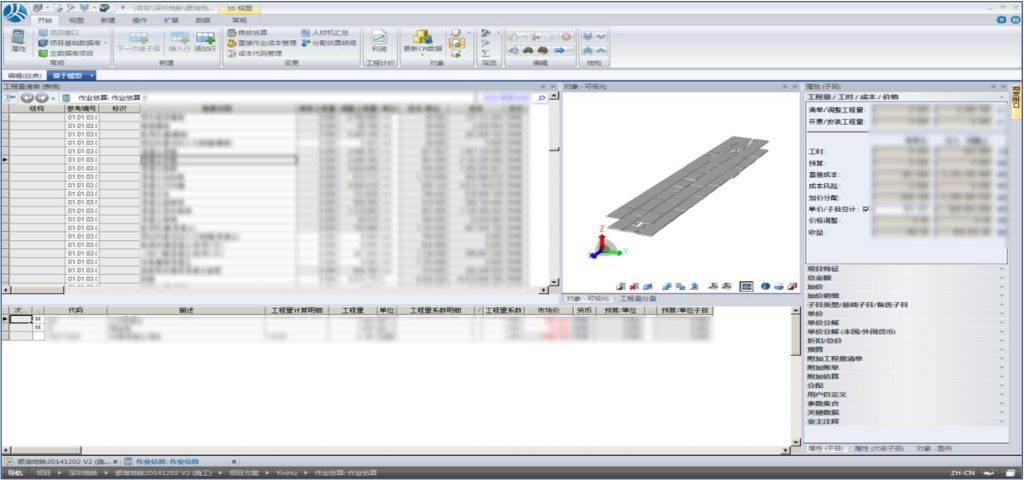

For Cost Control, iTWO enabled 3D model-based cost estimation, calculating the cost from enterprise quota standards. CPI (the index of spending cost and cost performance) was conducted on weekly basis to monitor the change and prevent cost overruns. Cost control was managed with iTWO in 3 areas:

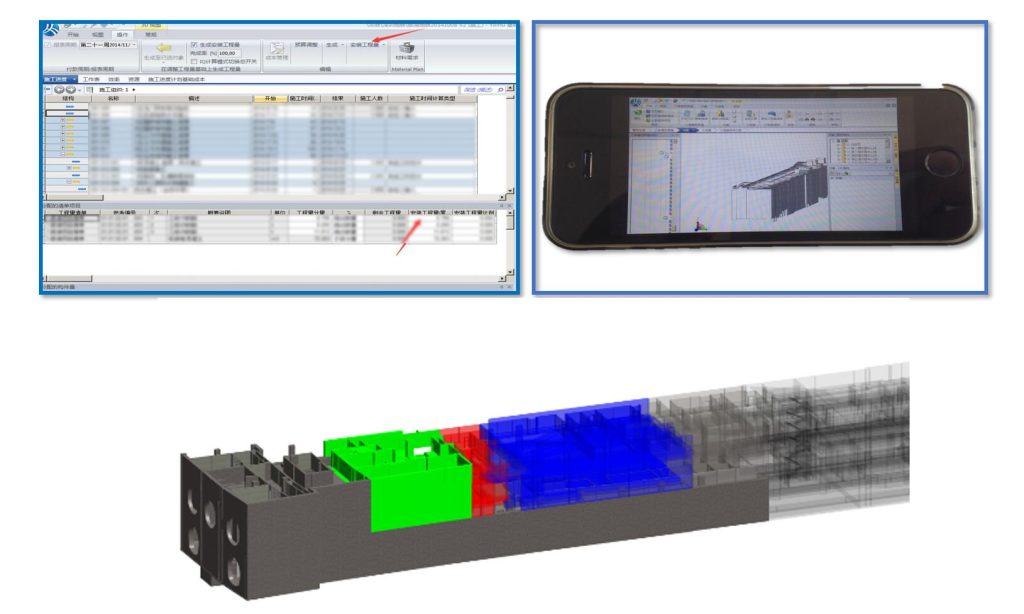

This whole project faced the challenges of a very tight schedule and numerous complex construction processes. With iTWO’s Schedule Management, the team ensured lean management of the scheduling, from planning, schedule simulation, actual schedule comparison, to the generation of weekly reports that gave a complete picture of all project aspects.

With iTWO, plans were calibrated, costs analyzed and compared, and schedules were optimized. The project team completed the structure cap 56 days before the planned date. The shield ground was handed over ahead of schedule.
CCFED achieved acclaim for the project, as well as the expected margins. They also received more metro project contracts after this project.
