Berlin-headquartered BUG Verkehrsbau SE has been building secure foundations for modern rail transport for over 3 decades. Today, this leading...

About Nagpur Metro Rail
Nagpur city is the winter capital of the state of Maharashtra, India, with a population of 46,53,570. The city boasts of being the geographical center of the nation.
Nagpur is also a major commercial and political center of the Vidarbha region of Maharashtra. Nagpur Metro Rail (https://www.metrorailnagpur.com) Project will consist of 38.215 Km metro corridor, 38 stations and 2 Depots. The entire stretch will be divided into 2 alignments or corridors as follows:


We chose iTWO because we found that it was giving us a very effective solution to our problems. iTWO implementation has gone very well so far, we have adopted 5D building information modeling based digital project management platform for the first time in India as far as large infrastructure project scope.
– Dr. Brijesh Dixit, Managing Director
Maharashtra Metro Rail Corporation Limited
The Nagpur Metro Rail project is a fairly complex one, with more than 20 major contractors working over a period of time for this project and around 30 subsystems including signaling system, telecom system, rolling stock, air conditioning, electrical, etc. thus a large amount of coordination is required for these systems to run together and a platform which has BIM management along with an integration software was best suited for the project’s requirement.
In order to have a better project information, to reduce cost overrun and time overrun, Nagpur Metro Rail Corporation Limited (NMRCL) decided right from the beginning that they would go for a digital project management for the complete project. In addition to this, the concept of asset management was planned right from the beginning so that all the construction details which the project develops will all be available for future maintenance of the metro system.
According to its unique requirements, NMRCL selected a few major digital project management systems including iTWO for efficient management of the project.

(Month wise Planned Vs Actual Cost Comparison in iTWO for better Controlling of the project)

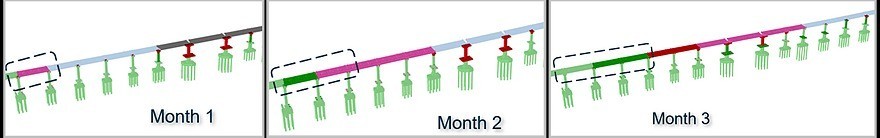

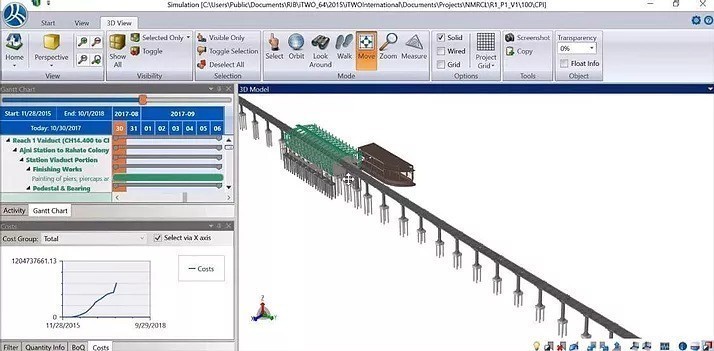

As the data entered was analyzed on a weekly and quarterly basis, NMRCL had model-based delay analysis, for example (below pictures), the progress of the project is showed in different colors: work completed in previous reporting month, work in progress in current reporting month, work planned in next reporting month, and delayed works in current reporting month. This way, a complete picture is always available for the management, allowing for efficient decision making.



Nagpur metro is considered to be a benchmark for future mega infrastructure projects in India and the key success factors are:
iTWO along with the other components of the digital project management platform has enabled us to undertake activities in a faster way, saving almost about 20% to 25% of the time, saving us cost, our project has been able to save almost about 10% of the cost so far. And we have been able to do all this, ensuring the high-quality standards and also high safety standards, in a manner that our complete lifecycle of the project becomes cost-efficient.
– Dr. Brijesh Dixit, Managing Director
Maharashtra Metro Rail Corporation Limited
Berlin-headquartered BUG Verkehrsbau SE has been building secure foundations for modern rail transport for over 3 decades. Today, this leading...
Max Bögl 简介 Max Bögl成立于1929年,是德国最大的建筑公司之一,在全球 40个地点拥有6,500多名优质员工,每年销售额约为 20亿欧元。官网:https://max-boegl.de/en 三维模型为施工现场的BIM使用打下了坚实的基础。 Evelyn RoßnerMax Bögl公司BIM专家 高速公路工程项目BIM施工应用 长期以来,建筑信息模型(BIM)并不局限于结构工程。BIM也能协助基础设施项目的前期规划、到竣工、再到使用和维护的全流程,以在施工过程中获得更高的安全性、更高的质量和灵活性。为了在 Max Bögl 的高速公路和排水工程业务领域积极推动 BIM 实施,在基础设施领域有着丰富经验的Evelyn Roßner被任命为 BIM...
“As little paper as possible“ is the credo during the execution of the construction processes at the district office of...
